Behind the scenes · 05-working-docs + 05-scope
internal scaffoldingThis phase produces working files, not a single customer-facing document. Listed below are the files ProposalGen authored. They feed into the polished steps before and after this one.
05-working-docs/
28 files- 06-commercial-rates.yamlOpen
- A1-io-list-AUDIT.xlsxOpen
- A1-io-list.yamlOpen
- A2-equipment-takeoff-AUDIT.xlsxOpen
- A2-equipment-takeoff.yamlOpen
- A3-cable-schedule-AUDIT.xlsxOpen
- A3-cable-schedule.yamlOpen
- A3-cable-spec-rules.yamlOpen
- A3-route-lengths.yamlOpen
- A4-panel-schedule-AUDIT.xlsxOpen
- A4-panel-schedule.yamlOpen

- A5-network-architecture.mdOpen
- A5-network.pngOpen
- A6-head-end-equipment.yamlOpen
- A7-power-provisions.yamlOpen
- B1-programming-objects.yamlOpen
- B1-trend-strategy.yamlOpen
- B2-graphics-pages.yamlOpen
- B3-commissioning-points.yamlOpen
- B4-installation-manhours.yamlOpen
- B4-site-factors.yamlOpen
- C1-co-matrix.mdOpen
- C2-coordination-matrix.mdOpen
- C3-inclusions-exclusions.mdOpen

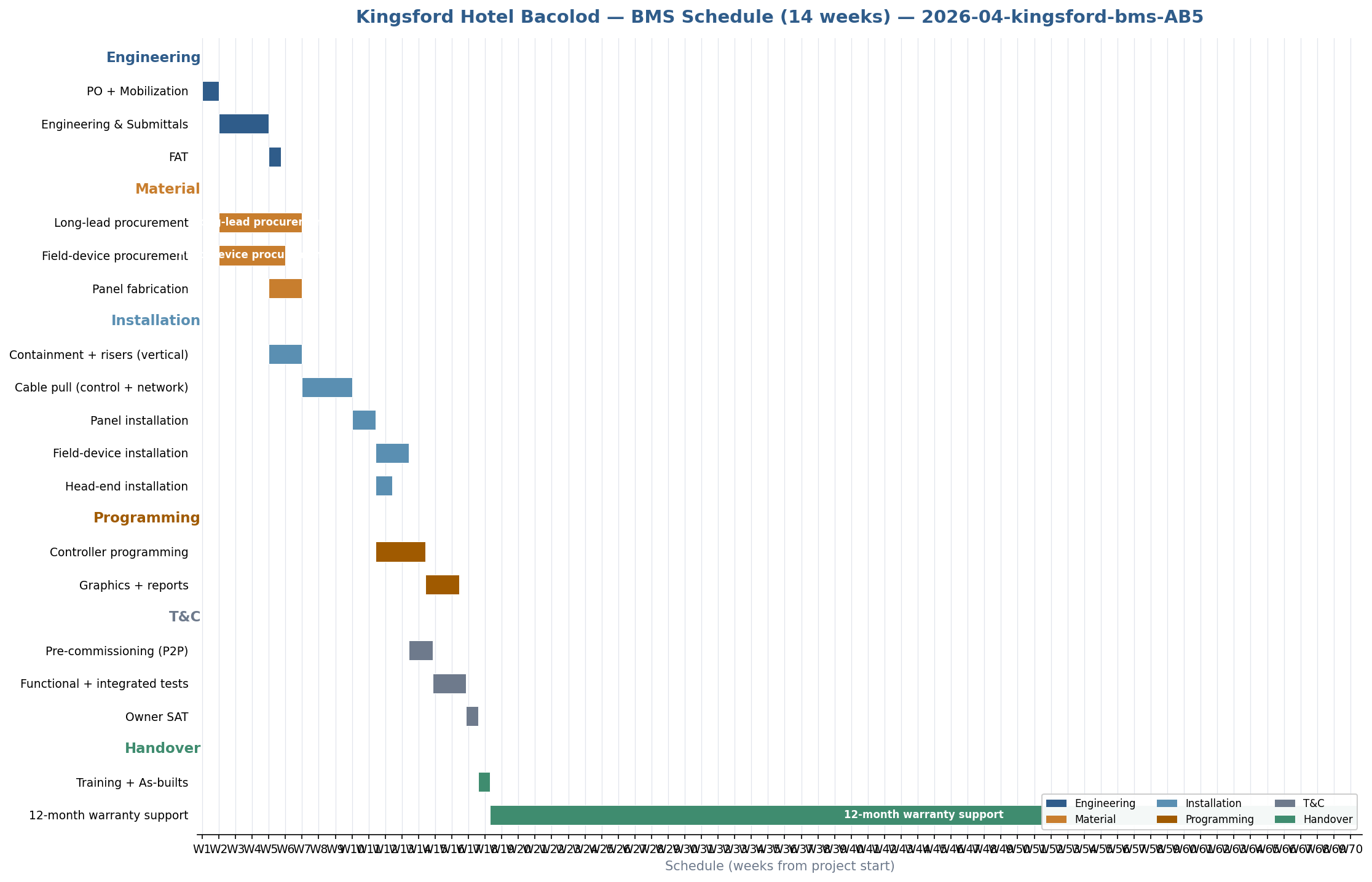

- D1-gantt.pngOpen
- D1-schedule.mdOpen
- D2-manpower-loading.mdOpen
- D3-risk-register.mdOpen
05-scope/
32 files- 1.1--project-management.mdOpen
- 1.2--engineering-design.mdOpen
- 1.3--submittals.mdOpen
- 1.4--fat.mdOpen
- 1.5--as-builts.mdOpen
- 2.1--head-end.mdOpen
- 2.2--network-infrastructure.mdOpen
- 2.3--controller-panels.mdOpen
- 2.4--field-devices-hvac.mdOpen
- 2.5--field-devices-plumbing.mdOpen
- 2.6--field-devices-power.mdOpen
- 2.7--cabling-and-containment.mdOpen
- 3.1--mobilization.mdOpen
- 3.2--containment-installation.mdOpen
- 3.3--cable-pulling.mdOpen
- 3.4--panel-installation.mdOpen
- 3.5--field-device-installation.mdOpen
- 3.6--network-installation.mdOpen
- 3.7--head-end-installation.mdOpen
- 4.1--controller-programming.mdOpen
- 4.2--graphics.mdOpen
- 4.3--reports-trends-alarms.mdOpen
- 4.4--schedules.mdOpen
- 4.5--hli-integration.mdOpen
- 4.6--network-configuration.mdOpen
- 5.1--pre-commissioning.mdOpen
- 5.2--functional-testing.mdOpen
- 5.3--integrated-testing.mdOpen
- 5.4--owner-sat.mdOpen
- 6.1--training.mdOpen
- 6.2--handover-docs.mdOpen
- 6.3--warranty.mdOpen
