Working Documents & Modules

The defensible scaffolding behind the BOQ — A-series working docs and per-WBS-leaf module instances.

This is the bookkeeping that makes the BOQ defensible. I authored each working doc (A1 I/O list, A2 equipment takeoff, A3 cable schedule, A4 panel schedule, etc.) and one module instance per WBS leaf. Most of these are YAML structured data, not customer-facing prose — they exist so every BOQ row has a citation back to a quantity that was reasoned, not guessed.

Behind the scenes · 05-working-docs + 05-scope

internal scaffolding

This phase produces working files, not a single customer-facing document. Listed below are the files ProposalGen authored. They feed into the polished steps before and after this one.

05-working-docs/

28 files
  • 06-commercial-rates.yamlOpen
  • A1-io-list-AUDIT.xlsxOpen
  • A1-io-list.yamlOpen
  • A2-equipment-takeoff-AUDIT.xlsxOpen
  • A2-equipment-takeoff.yamlOpen
  • A3-cable-schedule-AUDIT.xlsxOpen
  • A3-cable-schedule.yamlOpen
  • A3-cable-spec-rules.yamlOpen
  • A3-route-lengths.yamlOpen
  • A4-panel-schedule-AUDIT.xlsxOpen
  • A4-panel-schedule.yamlOpen

  • A5-network-architecture.mdOpen
  • A5-network.pngOpen
  • A6-head-end-equipment.yamlOpen
  • A7-power-provisions.yamlOpen
  • B1-programming-objects.yamlOpen
  • B1-trend-strategy.yamlOpen
  • B2-graphics-pages.yamlOpen
  • B3-commissioning-points.yamlOpen
  • B4-installation-manhours.yamlOpen
  • B4-site-factors.yamlOpen
  • C1-co-matrix.mdOpen
  • C2-coordination-matrix.mdOpen
  • C3-inclusions-exclusions.mdOpen

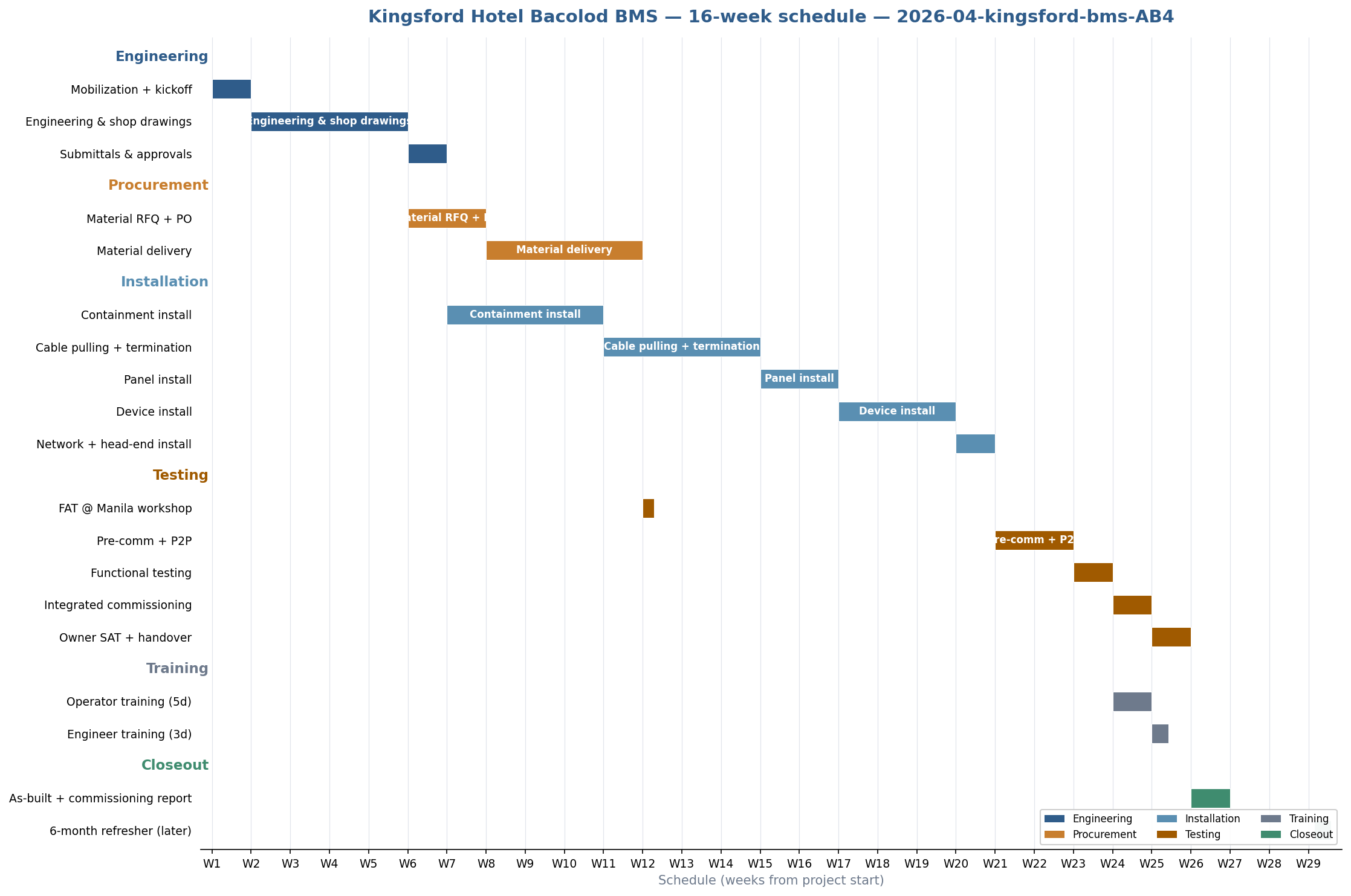

  • D1-gantt.pngOpen
  • D1-schedule.mdOpen
  • D2-manpower-loading.mdOpen
  • D3-risk-register.mdOpen

05-scope/

11 files
  • 1.1--bms-project-management-engineering.mdOpen
  • 1.2--bms-programming-engineering.mdOpen
  • 2.1-3.7--bms-head-end.mdOpen
  • 2.2-3.6--bms-network-infrastructure.mdOpen
  • 2.3-3.4--bms-controller-panel.mdOpen
  • 2.4-3.5.1--bms-field-devices-hvac.mdOpen
  • 2.5-3.5.2--bms-field-devices-plumbing.mdOpen
  • 2.6-3.5.3--bms-field-devices-power.mdOpen
  • 2.7-3.2-3.3--bms-cabling-and-containment.mdOpen
  • 5--bms-testing-commissioning.mdOpen
  • 6--bms-training-handover.mdOpen

Why I made these choices
