Behind the scenes · 05-working-docs + 05-scope
internal scaffoldingThis phase produces working files, not a single customer-facing document. Listed below are the files ProposalGen authored. They feed into the polished steps before and after this one.
05-working-docs/
24 files- A1-io-list-AUDIT.xlsxOpen
- A1-io-list.yamlOpen
- A1-page-coverage.mdOpen
- A2-equipment-takeoff-AUDIT.xlsxOpen
- A2-equipment-takeoff.yamlOpen
- A3-cable-schedule-AUDIT.xlsxOpen
- A3-cable-schedule.yamlOpen
- A4-panel-schedule-AUDIT.xlsxOpen
- A4-panel-schedule.yamlOpen
- A5-network-architecture.mdOpen

- A5-network.pngOpen
- A6-head-end-equipment.yamlOpen
- A7-power-provisions.yamlOpen
- B1-programming-objects.yamlOpen
- B2-graphics-pages.yamlOpen
- B3-commissioning-points.yamlOpen
- B4-installation-manhours.yamlOpen
- C1-co-matrix.mdOpen
- C2-coordination-matrix.mdOpen
- C3-inclusions-exclusions.mdOpen

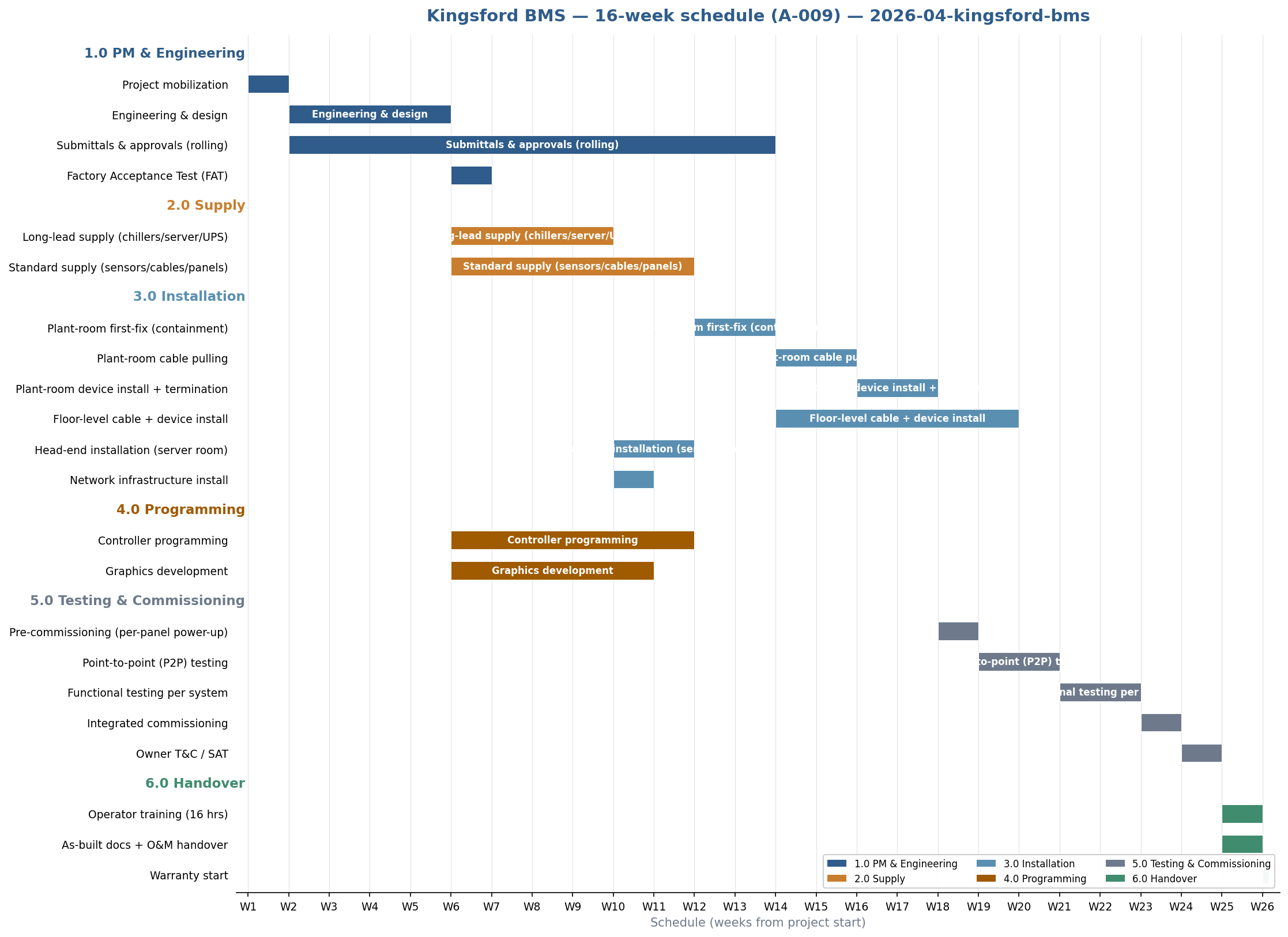

- D1-gantt.pngOpen
- D1-schedule.mdOpen
- D2-manpower-loading.mdOpen
- D3-risk-register.mdOpen
05-scope/
11 files- 1--project-management-engineering.mdOpen
- 2.1+3.7--head-end.mdOpen
- 2.2+3.6--network-infrastructure.mdOpen
- 2.3+3.4--controller-panel.mdOpen
- 2.4+3.5.1--field-devices-hvac.mdOpen
- 2.5+3.5.2--field-devices-plumbing.mdOpen
- 2.6+3.5.3--field-devices-power.mdOpen
- 2.7+3.2+3.3--cabling-and-containment.mdOpen
- 4--programming-engineering.mdOpen
- 5--testing-commissioning.mdOpen
- 6--training-handover.mdOpen
